31 Mai 2021 18:16 #1 by ffornarini
We have a problem exporting and reopening a project (gantt) from Projeqtor.
The duration of the tasks don't match.

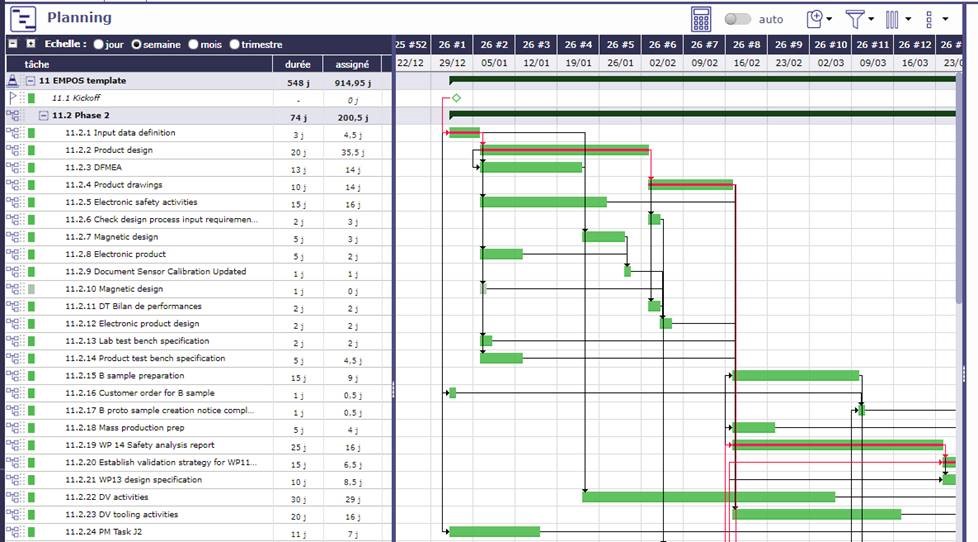

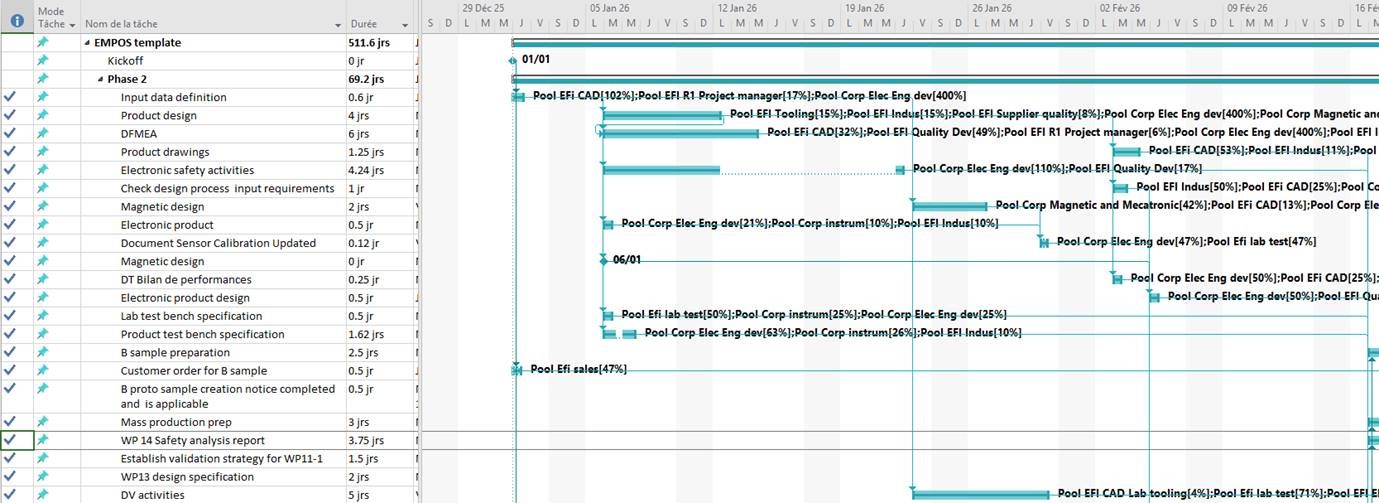

Example on the first 2 tasks on battached pictures :
- 'Input data definition ' task : 3 days on Projeqtor goes to 0.6day on MS project.
- "Product design" task : 20 days on projeqtor goes 4 days on MS project.



Have you ever seen this issues? Do you have a solution to are able to open the datas on MS project with the correct task durations.

Thanks for your help.
Attachments:

Please Connexion or Create an account to join the conversation.

More
04 Jui 2021 14:39 #2 by babynus
I guess it is because MS-Project does not manage Pools.
Moreover, you are using a "unique resource" planning for the pools.
MS-Project does not understand and uses full pool capacity...

This is a limit of export/import with tools than don't plan the same way.

Babynus
Administrator of ProjeQtOr web site

Please Connexion or Create an account to join the conversation.
